We are sharing the latest updates from the DESIRE Antalya construction site for Мarch.

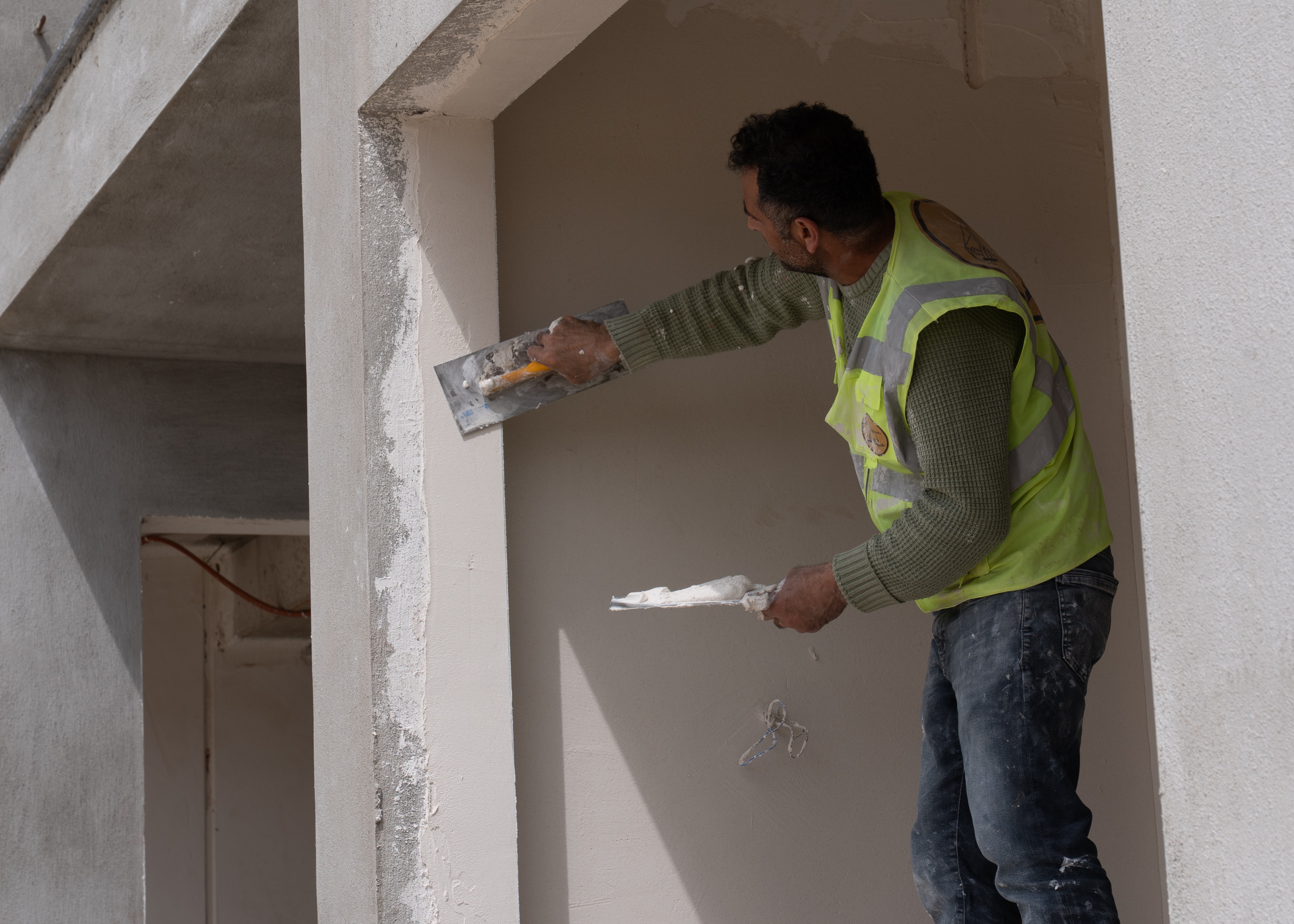

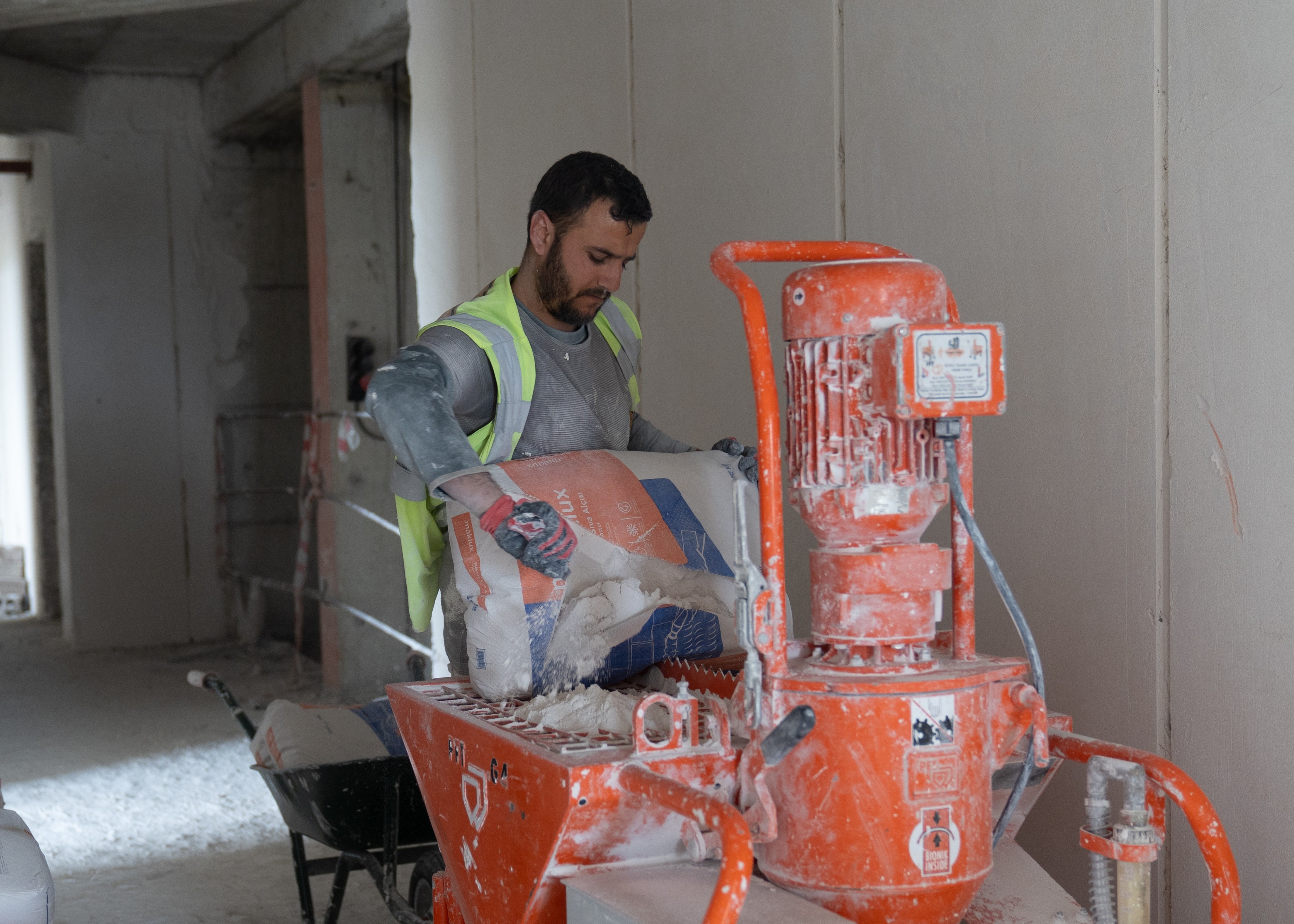

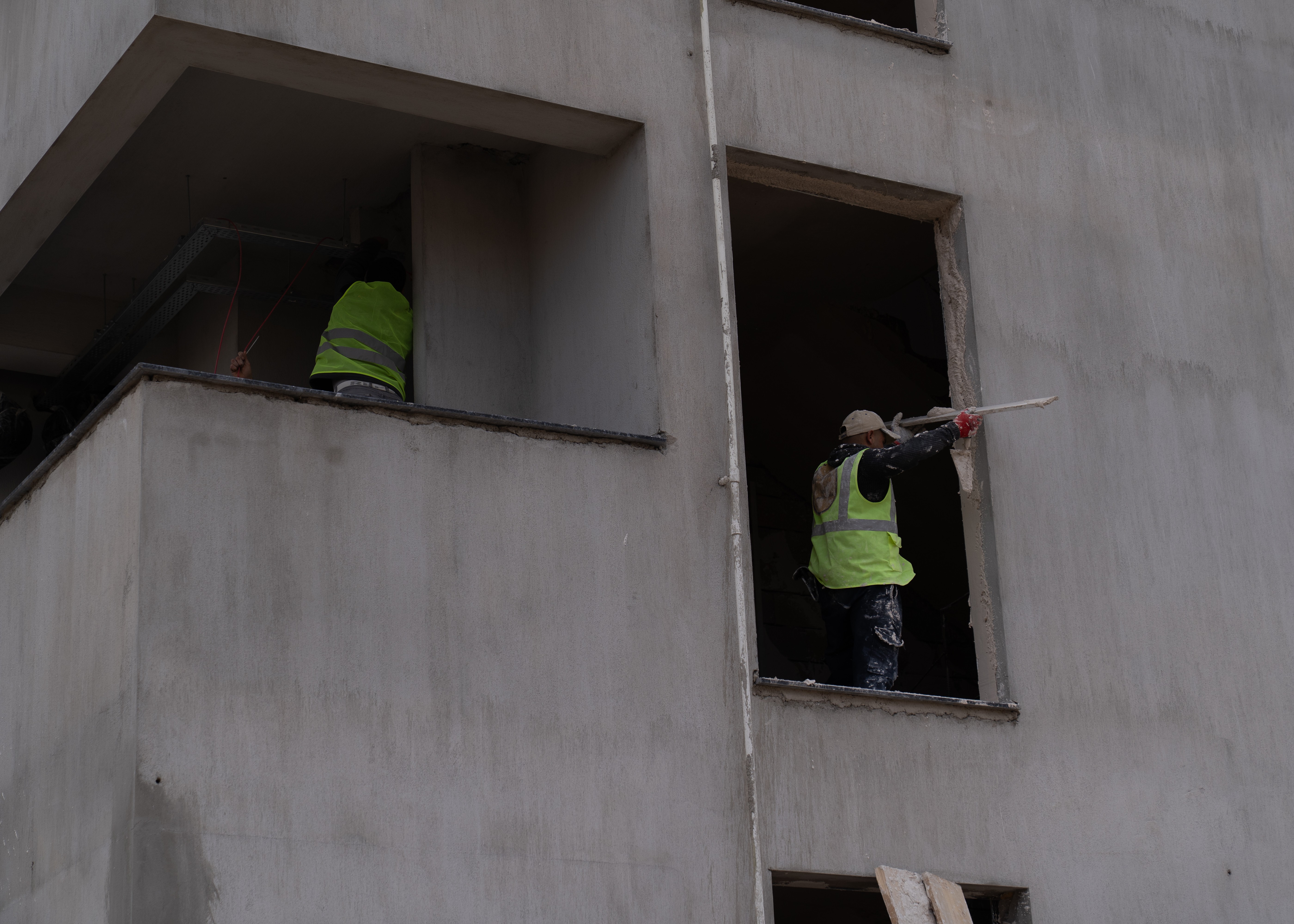

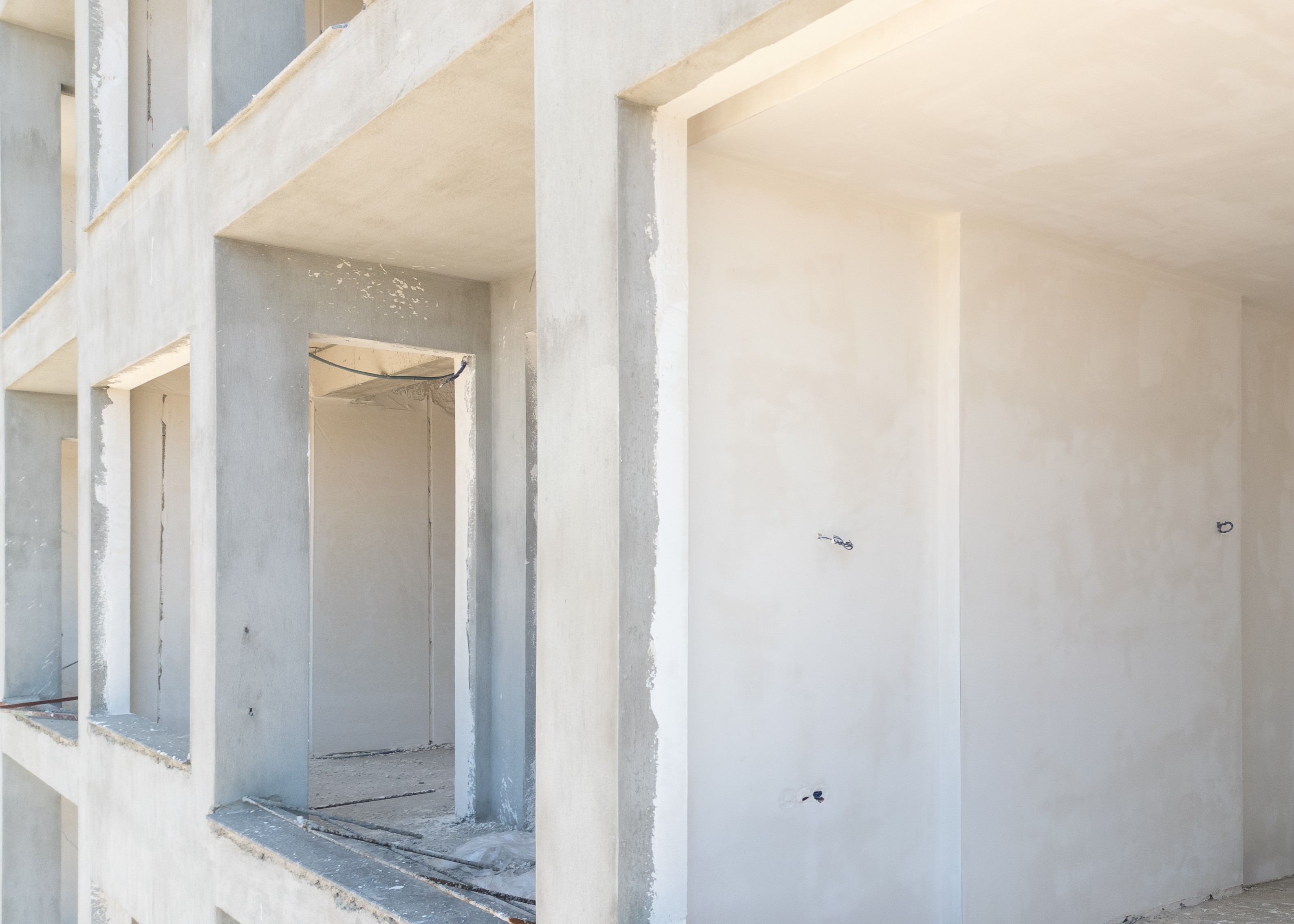

In Block A1, the installation of fire water supply piping has been completed on the ground and 3rd floors. Installation work of fire water supply pipes is ongoing on the 4th–7th floors. Gypsum-polymer plastering of apartments and halls has been completed on the ground and 2nd floors. Plastering work is in progress on the fire escape staircase from the 1st to the 3rd floor.

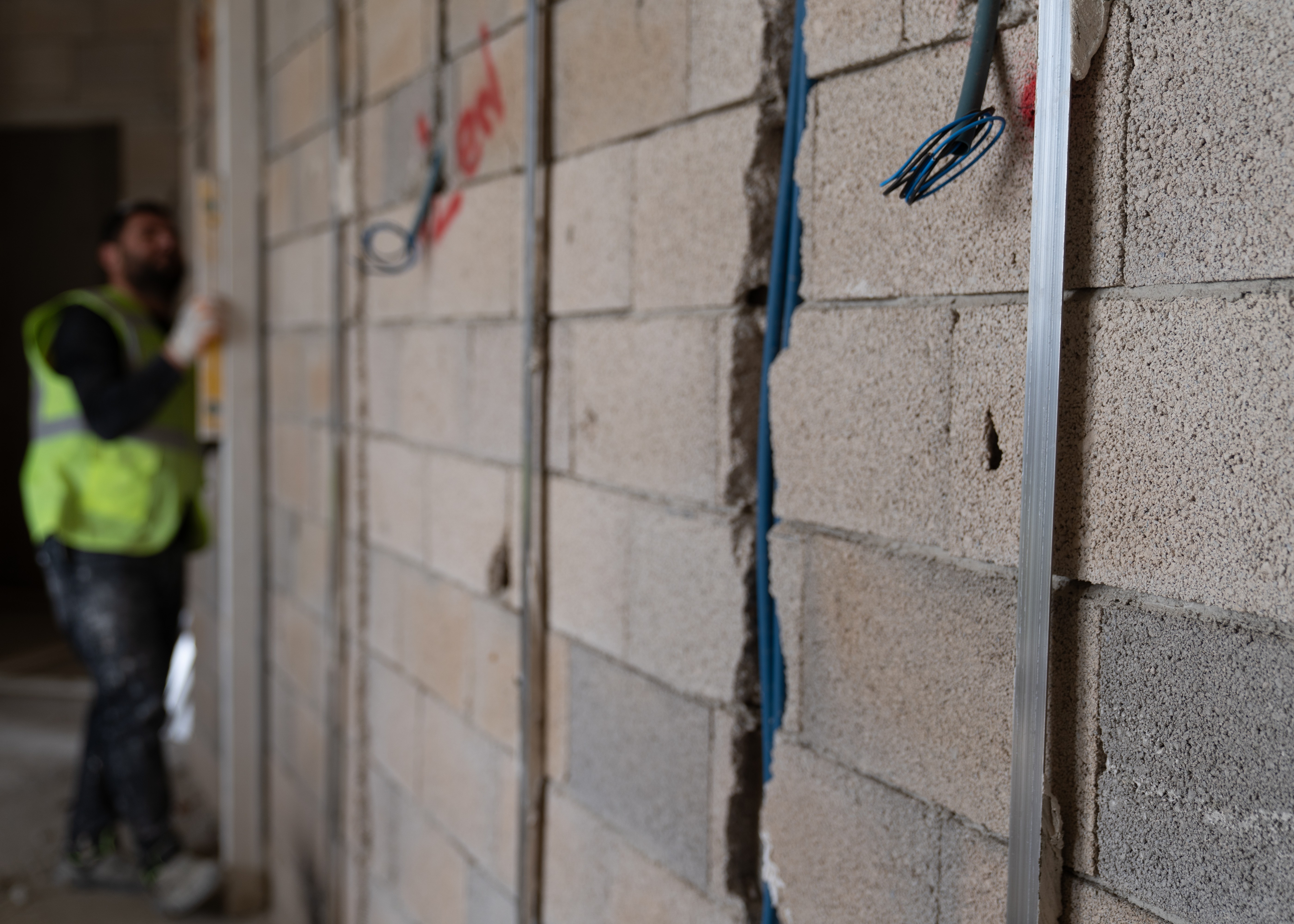

In Block A2, the installation of sewage risers has been completed, as well as the distribution of sewage and water supply pipes inside the apartments. Work is underway to pull electrical cables through the wiring channels in the apartments.
In Block A3, the installation of sewage risers and the distribution of sewage and water supply pipes inside the apartments have been completed.
The installation of marble window sills and drip edges has been completed throughout the building.

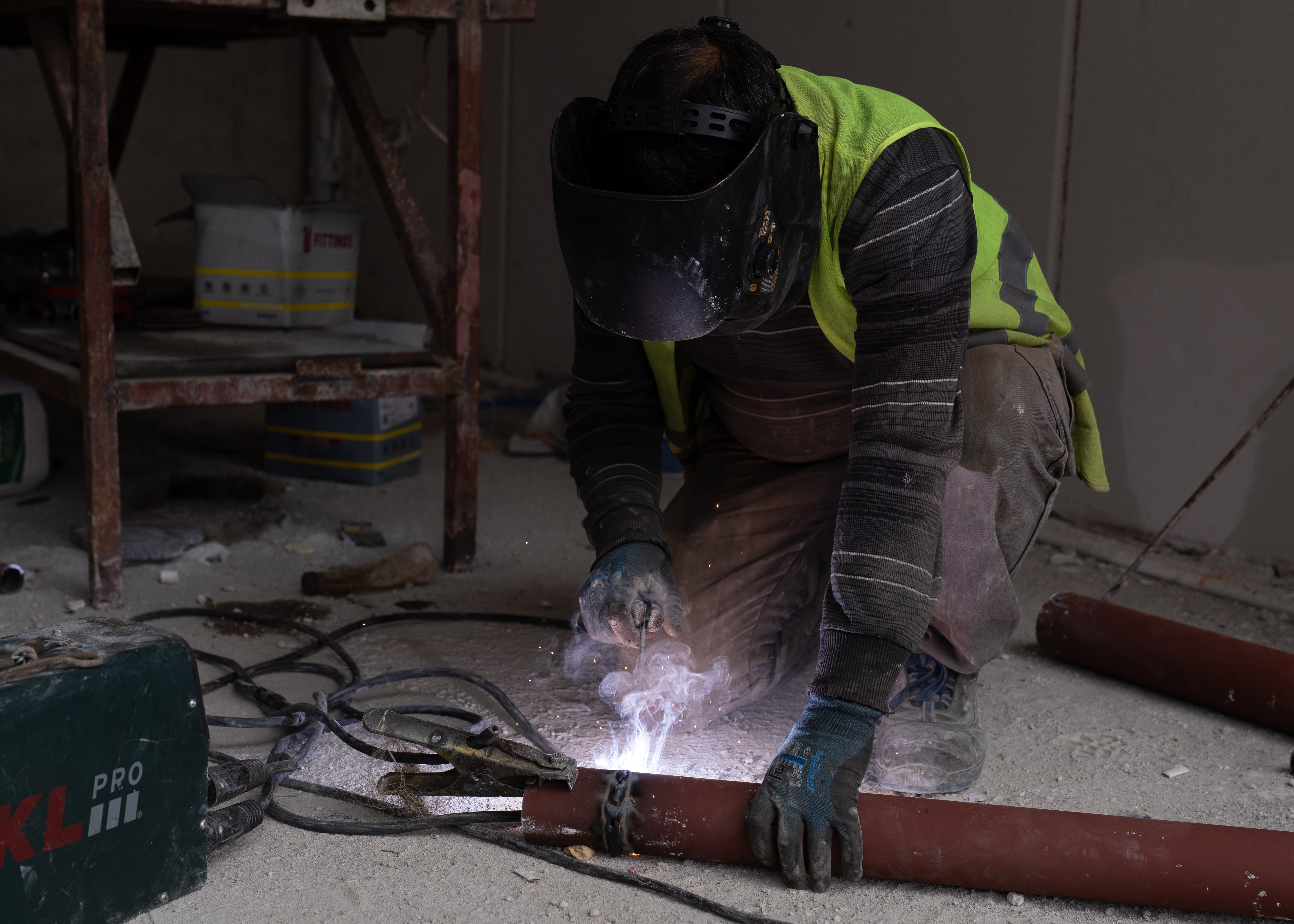

Work is underway in the basement to lay main sewage pipelines.
